For new construction roofing in Indianapolis, the central task is coordinating the roof design, deck readiness, drainage, trades and installation checks before the new commercial building is turned over. Those decisions affect how the building manages water and how problems are documented later. In Indianapolis, IN, CVC Roofing & Sheet Metal provides new construction roofing for commercial projects and brings 45+ years of combined industry experience to the work. To discuss a project, call (317) 557-0888.
This article explains how new construction roofing differs from replacement work, what a sound process includes, what an owner or general contractor can ask to see at each stage, and what signs mean a roofing plan needs attention before the roof goes on. The design team and authorities having jurisdiction establish applicable design and approval requirements; the roofing scope should identify its responsibilities and refer unresolved changes back for approval.
New Construction Roofing Requires a Different Approach

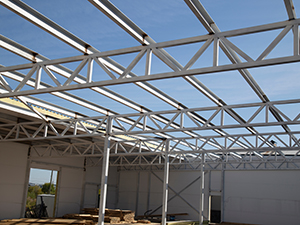

Replacement work starts with an existing roof and its problems. New construction starts with plans, so the roof can be built to match the building’s drainage design, structure, rooftop equipment, and use. That is an advantage, but only if the roofing contractor has an opportunity to identify conflicts early and bring them to the design team for resolution. Penetrations, curbs, edges, and transitions are common leak points on any roof, and on a new building they are also where trades overlap, which is when details get rushed or skipped.
For a commercial owner, the roof protects the building’s contents and operations. It is best treated as a complete assembly of deck, vapor control where needed, insulation, membrane, and flashings, not as a surface layer added at the end.

Common Roofing Systems Used on New Commercial Buildings
Flat and low-slope commercial buildings commonly use membrane systems. CVC installs single-ply roofing including TPO, PVC, and EPDM, and its new construction page also lists metal roofing for suitable commercial designs. The right choice depends on roof geometry, building use, rooftop equipment, foot traffic, and weather exposure. Low-slope buildings in particular depend on a drainage plan that moves water off the roof, which is discussed on the low-slope roofing in Indianapolis page.
Material choice is only part of the decision. Insulation, attachment method, and drainage affect performance as much as the membrane does. A roof can look fine at completion and still develop problems if water sits on it or if critical details were not installed carefully.
What a Quality New Construction Roofing Process Should Include
A sound process usually starts with plan review and coordination with the general contractor and other trades, so conflicts over rooftop units, penetrations, and schedule are resolved before roofing begins. The roof should go on at the right stage of construction, once deck condition, moisture and obstructions have been evaluated against the specified assembly and installation requirements. After that, the assembly is built in layers, with attention to vapor control where needed, insulation thickness and layout, attachment, and detailing at edges and transitions.
Quality control matters throughout. Seams, flashings, and penetrations should be checked as the work proceeds, and the finished roof should be reviewed for completeness before turnover. The table below lists what should happen at each stage, what evidence an owner or general contractor can request, and what signals a problem.
| Stage | What Should Happen | Evidence to Request | Trigger for Action |
|---|---|---|---|
| Plan review | The roofing contractor reviews drawings for roof type, slope, drains, and equipment locations. | Written notes or questions on the plans. | Drainage or penetration conflicts surface only after the roof is bid. |
| Trade coordination | Rooftop units, curbs, and penetrations are located and sequenced with other trades. | A coordination meeting record or schedule. | Other trades cut or add penetrations after roofing. |
| Deck readiness | The deck is checked for completion, suitability, moisture and obstructions before roofing begins. | Deck condition noted before installation begins. | Unresolved wet, damaged or obstructed deck areas are covered without an approved disposition. |

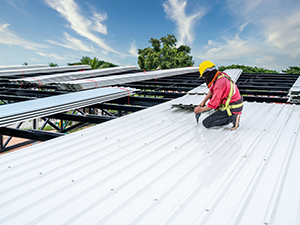

| Installation | Insulation, membrane, and flashings are installed to the specified details and attachment method. | Photos of key details and the product data used. | Substitutions are made without written approval. |
| Quality control | Seams, flashings, drains, and penetrations are inspected during and after installation. | Inspection notes or a punch list. | Open items are left until the end of the project. |
| Turnover | The finished roof is reviewed and specified turnover documents are delivered to the owner. | Applicable warranty documents, product information and the agreed final inspection record. | Documents are missing or warranty terms differ from the proposal. |
How New Construction Roofing Protects Long-Term Value
Consistent detailing, recorded inspections and accessible drains can make later maintenance more manageable. The roof assembly also helps manage moisture at the deck and building envelope, subject to conditions and installation quality. Insulation and air-control choices can influence indoor conditions, but energy or cost savings cannot be determined from roof installation alone. Roof performance also depends on the rest of the building and the final design.
Roofs on new buildings still need care. Plan regular inspections and prompt repairs when small issues appear, and keep the closeout records with the building’s files.
Choosing the Right Contractor for New Construction Roofing
New construction roofing takes experience with jobsite scheduling, safety requirements, and coordination with other trades. When assessing a contractor, ask these questions and expect written answers:
- How will you review the plans, and what questions do you expect to raise?
- How will rooftop equipment, penetrations, and other trades be coordinated with your work?
- Who is responsible for the deck being ready, and what happens if it is not?
- Which checks are included in the roofing scope, who signs them off, and what records will be turned over?
- Which warranty applies, and who issues it?
Answers that are specific and written down are a better sign than general assurances. If a contractor cannot say how it will handle coordination or inspection, treat that as a reason to ask further before awarding the work.
For a new commercial facility, an expansion, or a building that needs low-slope roofing, CVC Roofing & Sheet Metal can review the roofing plan with the owner or general contractor. To discuss a project in Indianapolis, call (317) 557-0888. Having the plans, schedule, and any specification sections available makes the conversation more specific.
Frequently Asked Questions
What is the biggest risk with new construction roofing?
Poor detailing, drainage planning, or trade coordination, which can lead to early leaks and avoidable repairs. Early plan review and inspection during installation reduce the risk.
How is new construction roofing different from roof replacement?
It starts from plans instead of an existing roof, so it involves plan review, coordination with other trades, and building the full assembly from the deck up.
Can a new commercial roof be designed for easier maintenance?
Yes. Good drainage, safe access, and consistent detailing make inspections and repairs simpler, which helps protect the roof over time.
When should the roofing contractor get involved in a new building project?
During design and before major roofing details are finalized, so drainage, equipment locations and penetrations can be coordinated with the design team instead of becoming field conflicts.
